How to Build a Construction Budget: From Estimate to Job Cost Control
An estimate wins the work. A budget controls it. They're not the same document. An estimate is built before the project to determine what to charge. A budget is built after contract award to define what the project can spend — organized by cost code, loaded into the job cost system, and tracked against actual expenditures from the first day of work to the last invoice.
Contractors who
run projects off the estimate — referring back to the bid document when they want to know if they're on track — are managing with a rearview mirror. By the time a scope item shows an overrun in the estimate comparison, the money is already spent. A properly structured budget with weekly actual-vs.-budget tracking by cost code shows overruns while there's still time to respond — not at project closeout.
The budget's data quality depends entirely on how accurately costs are recorded against it. Labor is the highest-risk category, and labor actuals flow from construction time tracking software — specifically from workers clocking in with project and cost code selected. A budget with accurate labor cost codes updated from daily time records is a live management tool. A budget where labor is entered weekly from memory or supervisor summaries is a rough approximation.
This guide covers how to convert an estimate into a working budget, how to structure it by cost code, how to connect it to time tracking and accounts payable, how to track and update it through the project, and the most common budget management failures that let margin erode invisibly.
For contractors who want better visibility between the field and office, construction management tools and features can help connect daily activity, labor costs, and project documentation in one system.
Estimate vs. Budget: The Distinction
|
Estimate |
Budget |
|
|---|---|---|
|
Purpose |
Determine selling price |
Control project spending |
|
Timing |
Before contract award |
After contract award |
|
Audience |
Owner, PM, principals |
PM, superintendent, accounting |
|
Organization |
By scope / CSI division |
By cost code mapped to accounting |
|
Overhead and profit |
Included in selling price |
Usually excluded (tracked separately) |
|
Living document? |
No — locked at bid |
Yes — updated for approved change orders |
An estimate includes markup — overhead and profit that build the selling price. A budget typically tracks only direct costs — what will actually be spent. Overhead is recovered through markup and tracked at the company level; profit is what remains after all direct and indirect costs.
Some contractors build "all-in" budgets that include general conditions and an overhead allocation per project — useful for tracking total project profitability in real time. This approach works best when connected to a construction WIP report that compares revenue earned to cost incurred including allocated overhead.
If your team is improving its overall project controls, the construction project management guide explains how budgets, schedules, documentation, and field communication work together.
Step 1: Organize the Estimate by Cost Code
The budget starts with the estimate, reorganized into the company's standard cost code structure.
Estimate line items → budget cost codes:
|
Estimate Line |
Budget Cost Code |
Budget Amount |
|---|---|---|
|
Framing labor — 400 hrs × $49.30 |
06-100 Labor |
$19,720 |
|
Framing material — lumber + hardware |
06-110 Material |
$31,400 |
|
Drywall labor — 280 hrs × $44.20 |
09-250 Labor |
$12,376 |
|
Drywall material — board + fasteners |
09-260 Material |
$18,900 |
|
Painting sub bid |
09-900 Subcontract |
$22,500 |
|
Superintendent — 12 weeks × $1,850/wk |
01-110 GC Labor |
$22,200 |
|
Temporary utilities |
01-200 GC Cost |
$3,600 |
Every estimate line maps to exactly one cost code. If the estimate has a line that doesn't fit any cost code in the library, either add a code or map it to the closest existing code and note it.
Two common problems:
- Estimate organized differently than the cost code structure — requires manual remapping
- Sub-tier scopes bundled in the estimate that need to be split into separate cost codes
Both are fixed by standardizing the estimate template to match the cost code structure from the start. If estimates and budgets use identical line item organizations, the conversion is a copy-paste, not a remapping exercise.
Step 2: Enter the Budget into the Job Cost System
Once cost codes are assigned, load the budget into the accounting or project management system:
- Project created with contract amount, start date, and projected completion
- Each cost code entered with budget hours (for labor codes) and budget dollars
- Subcontract line items entered with the awarded subcontract amounts
- General conditions entered by item
Labor budget: hours AND dollars
Labor cost codes need both hour budgets and dollar budgets. Hours allow labor efficiency ratio tracking (actual hours vs. budget hours). Dollars allow cost comparison. A labor cost code that tracks only dollars can show on-budget spending that's actually running over in hours — because wage rates changed or crew composition shifted.
Example labor budget entry:
Cost Code: 06-100 Framing Labor Budget Hours: 400 Budget Cost: $19,720 Avg Rate: $49.30/hr
When workers clock into code 06-100, the system accumulates actual hours and calculates actual cost. At any point: actual hours ÷ budget hours = percent of labor budget consumed.
Step 3: Connect Time Tracking to the Budget
The budget is only as accurate as the actuals that flow into it. For labor — the largest and most variable cost category — actuals come from construction employee time tracking.
The connection:
- Worker clocks into Project 47, cost code 06-100 at 7:02am
- Worker clocks out at 3:48pm — 8.77 hours logged
- Time tracking system exports daily time entries
- Accounting/job cost system imports entries — adds 8.77 hours and $432.36 to cost code 06-100 actuals
- Budget report shows 06-100: 48.2 actual hours vs. 400 budget hours = 12% consumed
This loop runs daily. By Wednesday morning, the PM sees Monday and Tuesday's labor actuals against every cost code. Problems are visible within 48 hours of occurring — not at month-end.
What breaks this loop:
- Workers clocking into the project without selecting a cost code (hours go to unallocated)
- Workers clocking into the wrong cost code (hours inflate one code while starving another)
- Time entries not exported/imported daily (weekly batching delays visibility by a week)
A contractor time tracking app that requires cost code selection and integrates directly with the job cost system closes both gaps. Workers can't clock in without a code; data flows automatically without a manual export step.
Step 4: Budget Structure for a Complete Project
Full budget structure example — commercial renovation, $650,000 contract:
DIRECT COSTS Division 01 — General Conditions 01-110 Superintendent labor $28,400 01-120 Project engineer $14,200 01-200 Temp utilities $4,800 01-210 Temp facilities $3,200 01-220 Small tools/consumables $2,600 01-230 Dumpsters $3,900 01-240 Safety $1,800 01-250 Final cleaning $2,200 GC Total: $61,100 Division 06 — Framing 06-100 Framing labor $19,720 06-110 Framing material $31,400 Framing Total: $51,120 Division 09 — Finishes 09-200 Metal framing labor $8,400 09-210 Metal framing material $6,200 09-250 Drywall labor $12,376 09-260 Drywall material $18,900 09-300 Tile labor $11,200 09-310 Tile material $14,600 09-650 Flooring (sub) $34,500 09-900 Painting (sub) $22,500 Finishes Total: $128,676 Division 22 — Plumbing (sub) $84,000 Division 23 — HVAC (sub) $96,000 Division 26 — Electrical (sub) $118,000 TOTAL DIRECT COST: $538,896 Contingency (3%): $16,167 TOTAL PROJECT BUDGET: $555,063 Contract Amount: $650,000 Overhead Allocation (14%): $77,613 Target Profit: $17,324 (2.7% net margin)
Step 5: Tracking Actuals Against Budget
Weekly Budget Report
Every week, review actual vs. budget by cost code:
|
Code |
Scope |
Budget $ |
Actual $ |
Remaining $ |
% Used |
Status |
|---|---|---|---|---|---|---|
|
06-100 |
Framing labor |
$19,720 |
$14,280 |
$5,440 |
72% |
On track |
|
06-110 |
Framing material |
$31,400 |
$28,900 |
$2,500 |
92% |
Watch |
|
09-250 |
Drywall labor |
$12,376 |
$4,100 |
$8,276 |
33% |
On track |
|
09-260 |
Drywall material |
$18,900 |
$19,840 |
−$940 |
105% |
Over |
Drywall material over budget at 105% — with work not complete — needs immediate investigation. Was there material waste, incorrect quantities in the estimate, or a price increase not captured?
Percent complete check: A cost code at 105% of budget but only 80% of scope complete is severely over-budget. A code at 105% of budget with scope 100% complete is slightly over but the damage is done. The difference determines urgency of response.
Labor efficiency column: For labor codes, add a column comparing actual hours vs. budget hours. A code spending within budget but consuming more hours than budgeted indicates wage rates are lower than estimated — which could mean the wrong workers are on the scope.
Forecasting Cost at Completion
For each cost code, project the final cost based on current trend:
Projected final cost = Actual cost to date ÷ Percent complete
If framing material is $28,900 spent at 92% of budget but scope is only 85% complete: $28,900 ÷ 0.85 = $34,000 projected final cost vs. $31,400 budget
Projected overrun: $2,600. Identified at 85% completion — there may still be time to reduce waste or substitute materials on remaining scope.
This forecasting approach feeds directly into the Construction WIP Report, which uses cost-at-completion projections to calculate estimated profit at completion vs. bid margin.

Step 6: Incorporating Change Orders
.jpg?width=600&height=450&name=3%20(43).jpg)
Every approved change order updates the budget:
- New cost codes created for change order scope (or existing codes adjusted if within current scope)
- Budget amounts increased by approved change order cost
- Contract amount updated by approved change order value
- Projected profit recalculated
A change order that adds $15,000 in labor and materials with a $20,000 approved price increases the contract value by $20,000 and the budget by $15,000. The $5,000 margin on the change order should be visible in the WIP report as additional projected profit.
Unapproved change orders in the budget: When change order work is proceeding but approval is pending — common on T&M work — add the scope to the budget as a "pending" line at estimated cost. Track actuals against the pending budget. When approved, convert pending to approved and update the contract amount. This approach prevents pending change order costs from showing as unexplained overruns in the base scope budget.
For general contractors managing multiple scopes and subcontractors, project management software for general contractors can help keep budgets, field updates, and documentation organized.
For roofing companies with fast-moving crews and frequent field updates, roofing contractor project management software can help connect labor, photos, and project communication.
Step 7: Budget Revisions
Budgets should be revised when:
- Approved change orders are executed
- A significant scope clarification materially affects cost in a cost code
- An actual cost exceeds budget due to a quantifiable, verifiable cause (material price spike, differing site condition, owner-caused impact)
Budgets should NOT be revised to mask performance problems. A framing labor budget that ran over because of poor productivity is an overrun — revising the budget upward to make the variance go away defeats the purpose of having a budget.
Budget revision log: Track every budget revision with date, amount, cost codes affected, and reason. This log is part of project financial documentation — useful for dispute resolution and post-project analysis.
Cash Flow Projection from the Budget
The budget provides the cost side of the cash flow projection. Combined with the billing schedule (when revenue will be received), it produces the project cash flow forecast.
Inputs from the budget:
- Projected cost by month (based on schedule and budget distribution)
- Subcontractor payment timing (based on sub billing cycles and pay-when-paid provisions)
- Payroll timing (weekly, bi-weekly)
- Material payment timing (30-day net, immediate if COD)
Cash flow risk factors tracked against budget:
- Retainage withheld (see Construction Retainage) — reduce monthly revenue by retainage percentage
- Change order billing timing — approved but not yet billed change orders are earned but unreceived revenue
- Subcontractor payments — timing mismatch between when GC pays sub and when GC receives owner payment
See Construction Cash Flow Management for the full cash flow projection methodology using the budget as the foundation.
Accurate field records make budget reviews more reliable. Teams comparing documentation platforms may also want to review the TaskTag vs CompanyCam comparison to understand how project documentation tools differ for contractors.

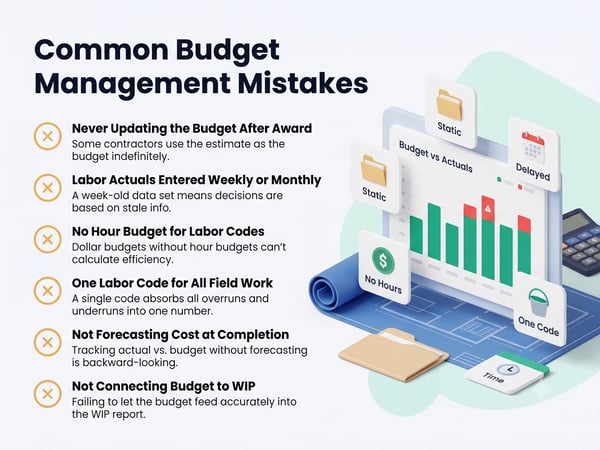

Common Budget Management Mistakes
.jpg?width=600&height=450&name=3%20(44).jpg)
Never updating the budget after award. Some contractors use the estimate as the budget indefinitely. Approved change orders aren't incorporated. By mid-project, the "budget" has no relationship to the actual contract or projected costs.
Labor actuals entered weekly or monthly instead of daily. A week-old labor data set means the PM is making decisions based on stale information. Daily construction time keeping software exports to the job cost system keep the budget current.
No hour budget for labor codes — only dollars. Dollar budgets without hour budgets can't calculate labor efficiency ratios. A cost code spending within dollar budget but running over hours is invisible — until the hours cause an overrun in the final weeks when productivity catches up with the math.
One "labor" code for all field work. See the cost codes discussion — a single labor code absorbs all overruns and underruns into a single number. No diagnostic value. A framing overrun that could have been caught and corrected at week 4 is discovered at project closeout.
Not forecasting cost at completion. Tracking actual vs. budget without forecasting the final position is backward-looking. The budget report should show both "how much have we spent" and "how much will we spend at this rate." The second question is the actionable one.
Not connecting budget to WIP. The budget feeds the WIP report. Without the connection, the WIP is an approximation; with it, the WIP reflects real cost-at-completion forecasts by cost code. See Construction WIP Report.
Contractors who want to improve job cost control can review TaskTag pricing plans to compare options for field documentation and project tracking.
You can also book a TaskTag demo to see how field data, documentation, and project workflows can support better job cost visibility.
If you are ready to start, you can create a free contractor account and begin organizing project information in one place.
For more contractor resources, visit the construction management resources library.
To learn more about the company, read About TaskTag.
Budget Setup Checklist
At contract award:
- [ ] Estimate remapped to cost code structure — every line assigned a code
- [ ] Budget loaded into job cost system by cost code
- [ ] Labor codes include both hour and dollar budgets
- [ ] Subcontract amounts entered as separate line items per sub
- [ ] General conditions entered by item, not lump sum
- [ ] Contingency entered as separate line
- [ ] Budget reviewed by PM and superintendent before work starts
Weekly during project:
- [ ] Time tracking actuals flowing to job cost system daily
- [ ] Actual vs. budget report reviewed by cost code weekly
- [ ] Cost codes over 90% of budget flagged for scope completion check
- [ ] Labor efficiency ratio reviewed for production codes
- [ ] Cost-at-completion forecast updated for flagged codes
Change orders:
- [ ] Every approved CO incorporated into budget within 48 hours of execution
- [ ] Pending CO work tracked as separate pending budget lines
- [ ] Contract amount updated to match approved CO value
Related Resources
TaskTag Features
- GPS Time Tracking for Construction — daily labor actuals by cost code feeding the budget in real time
- Construction Time Tracking Software Guide — job cost integration that connects time data to budget tracking
- Time Tracking for Construction Workers — cost code clock-in that populates labor budget actuals
- Top 5 Construction Time Tracking Apps — apps with job cost and budget integration
- Top 5 BusyBusy Alternatives — budget-integrated time tracking alternatives
- TaskTag vs. BusyBusy — job cost and budget tracking comparison
Related Blog Posts
- Construction WIP Report — budget feeds cost-at-completion in WIP reporting
- Construction Cash Flow Management — budget as the cost input to cash flow projection
- Contractor Profit and Loss Statement — project budget rolling into company P&L
- Construction Retainage — retainage impact on budget cash flow
- Construction Project Delay — delay cost impact on budget and cost-at-completion
- How to Negotiate a Construction Contract — contract terms that affect budget structure (GMP, cost-plus, lump sum)
- Construction Project Closeout — final budget reconciliation and closeout cost codes
