Construction Equipment Management: How to Track and Maintain Your Fleet

Construction Equipment Management: How to Track and Maintain Your FleetConstruction equipment sits idle 40–60% of the time on average — and idle equipment still costs money. A $180,000 excavator sitting on a job site not working costs its owner roughly $85–$120/day in ownership expense: depreciation, insurance, interest, and storage. Over a 250-day year, that machine needs to bill out enough hours to cover $21,000–$30,000 in fixed ownership cost before it generates a dollar of profit. Most contractors don't know their actual equipment utilization rate because they've never tracked it.

Equipment management is the practice of maximizing the productive use of owned and rented equipment, minimizing downtime through preventive maintenance, allocating equipment cost accurately to jobs, and making data-driven decisions about when to buy, rent, or sell. The contractors who do it well have lower equipment cost per unit of work produced, fewer emergency repairs, and job cost reports that actually reflect what equipment costs — not what it costs when it breaks down unexpectedly.

The connection to construction time tracking software is direct: operator hours logged by cost code via construction time clock app are the primary mechanism for allocating equipment cost to projects and tracking utilization. An operator clocked to cost code 02.200 (earthwork) is not just a labor record — it's the trigger for charging the equipment they're operating to the same cost code.

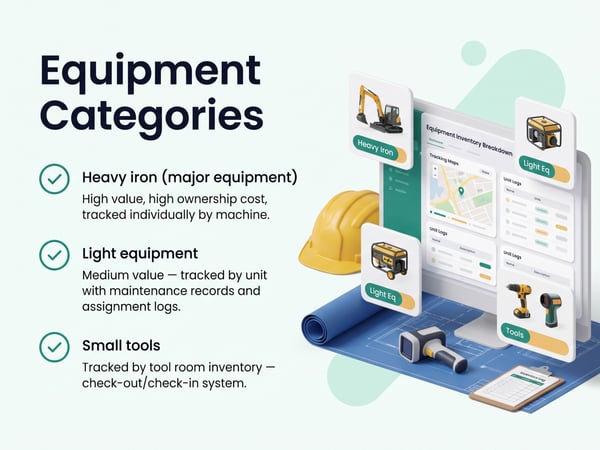

Equipment Categories

Equipment Categories

Not all equipment management looks the same. Different equipment types require different tracking approaches.

Heavy iron (major equipment):

  • Excavators, bulldozers, motor graders, scrapers
  • Tower cranes, crawler cranes, mobile cranes
  • Concrete pumps, batch plants
  • Compactors, pavers, milling machines

High value, high ownership cost, tracked individually by machine. Telematics (GPS, engine hours, fuel data) standard on most modern machines. Scheduling and utilization tracking essential at this tier.

Light equipment:

  • Skid steers, mini-excavators, telehandlers, forklifts
  • Generators, light towers, air compressors
  • Concrete saws, plate compactors, jumping jacks
  • Pump trucks, pressure washers

Medium value — tracked by unit with maintenance records and assignment logs. Scheduling across projects critical because demand can exceed fleet capacity.

Small tools:

  • Power tools, hand tools, safety equipment
  • Laser levels, transits, measuring equipment

Tracked by tool room inventory — check-out/check-in system. Individual replacement cost low but aggregate theft and loss is significant: a poorly managed tool inventory loses $5,000–$25,000+/year on an active commercial project.


Equipment Cost: What It Actually Costs to Own a Machine

Most contractors underestimate equipment cost because they only count what they paid for the machine. Ownership cost has four components.

Total cost of equipment ownership:

Cost Component

Calculation Basis

Depreciation

Purchase price ÷ useful life (years)

Interest / Opportunity cost

Outstanding balance × interest rate

Insurance

Annual premium allocated per machine

Major repairs and overhaul

Historical average per machine-hour

Preventive maintenance

Fluid, filters, scheduled service per interval

Tires / undercarriage / wear items

Replacement cost ÷ expected life (hours)

Storage and transportation

Annual cost allocated per machine

Internal rental rate = total annual ownership cost ÷ projected billable hours

Example — 45,000 lb excavator:

  • Purchase price: $280,000
  • Useful life: 10,000 hours (approx. 8–10 years)
  • Annual ownership cost (depreciation + interest + insurance + maintenance): ~$42,000
  • Target annual utilization: 1,200 hours
  • Internal rental rate: $42,000 ÷ 1,200 = $35/hour

Every hour the excavator operates, $35 is charged to the project's equipment cost code. Every hour it sits idle, $35 is absorbed by overhead. The internal rental rate makes equipment cost visible and gives the PM the number to include in bids.

FHWA Equipment Watch and Caterpillar's rental rate guides publish ownership and operating cost data by machine type — use these as starting points, then adjust for your actual financing, insurance rates, and local maintenance costs.


Equipment Tracking: Utilization, Location, and Assignment

Utilization rate = actual productive hours ÷ available hours

A machine with 1,200 available working hours (250 days × 8 hrs, minus holidays) that logged 720 billable hours runs at 60% utilization. Industry average for owned fleet: 50–65%. World-class: 70–80%.

Tracking utilization requires logging hours. Three ways to do it:

Operator time tracking (most practical for mixed fleets): Operator clocks in via contractor time tracking app, selects project, cost code, and equipment ID. Every hour the operator works = one hour of equipment utilization on that project. The construction timesheet app exports operator hours by equipment ID — utilization data without telematics.

Engine hour meters: Most equipment has built-in hour meters. Manual log: record hours at the end of each shift or when the machine moves between projects. Accurate but requires discipline to maintain.

Telematics (OEM or aftermarket): Modern heavy equipment transmits GPS location, engine hours, idle hours, fuel consumption, fault codes, and diagnostic data via cellular connection. Caterpillar VisionLink, Komatsu SmartConstruction, John Deere Operations Center — or aftermarket systems (Trimble, Trackunit, Samsara) retrofitted to older machines.

Telematics gives the most complete picture but requires subscription cost and setup. For newer heavy iron, it's standard. For light equipment, operator time tracking via construction crew time tracking app is usually sufficient.

Equipment location tracking: GPS location data from GPS time tracking on operators plus telematics on equipment answers: where is each machine right now? Critical for multi-site operations, subcontractor equipment management, and theft prevention.

Assignment log: Every machine assignment should be documented: machine ID, project, assigned operator, start date, expected return date. When a machine moves, the log updates. Without an assignment log, "where is the 85,000 lb excavator" becomes a phone call to three foremen.


Preventive Maintenance: The Discipline That Prevents Downtime

A machine that breaks down on a critical path activity costs more than the repair — it costs the idle crew time, the emergency rental, the schedule delay, and the subcontractor coordination to reschedule work that was blocked. Emergency repairs run 2–5× the cost of the same repair performed as preventive maintenance.

PM intervals by component:

Interval

Typical Services

Daily

Walk-around inspection, fluid levels, track/tire condition, safety items

250 hours

Engine oil and filter, fuel filter, hydraulic return filter

500 hours

Final drive oil, swing drive oil, pilot filter

1,000 hours

All filters, hydraulic oil, coolant check, undercarriage wear check

2,000 hours

Major fluid changes, detailed undercarriage inspection, major component inspection

Per manufacturer

Belts, hoses, bucket teeth, cutting edges, wear plates

Pre-shift operator inspection: Every operator completes a walk-around inspection at the start of each shift — fluid levels, leaks, tire/track condition, safety equipment, lights, warning systems. A 5-minute inspection that catches a hydraulic leak before startup prevents an 8-hour repair and a towed machine.

Maintenance log per machine: Every service performed — date, hours at service, parts replaced, technician, next service due — recorded in the machine's maintenance history. The maintenance log is also required for warranty claims and is a significant factor in resale value.

GPS + operator time tracking supports PM scheduling: When operator hours log by machine ID via construction time tracking app, the fleet manager can track accumulated hours per machine automatically. A PM alert at 240 hours flags the machine for 250-hour service before the interval is missed.


Equipment Scheduling Across Projects

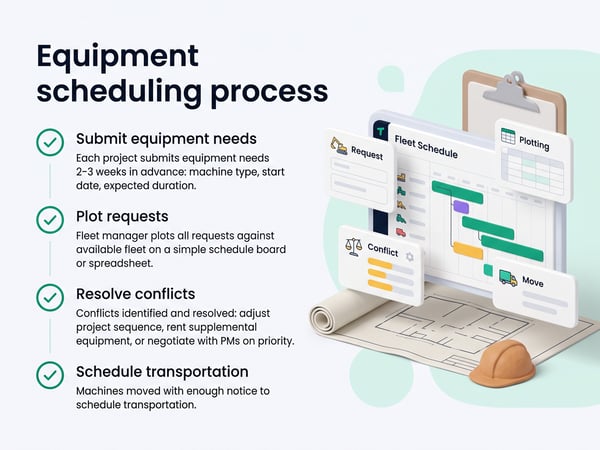

Equipment Scheduling Across Projects

A fleet shared across multiple projects needs active scheduling — otherwise two project superintendents call for the same excavator on the same Monday and one project goes idle.

Equipment scheduling process:

  1. Each project submits equipment needs 2–3 weeks in advance: machine type, start date, expected duration
  2. Fleet manager plots all requests against available fleet on a simple schedule board or spreadsheet
  3. Conflicts identified and resolved: adjust project sequence, rent supplemental equipment, or negotiate with PMs on priority
  4. Machines moved with enough notice to schedule transportation

When to rent vs. use owned equipment:

Situation

Recommendation

Short duration (< 4 weeks) on a specialized machine

Rent — ownership cost amortizes poorly on short runs

Machine needed while owned unit is down for maintenance

Rent a replacement

Multiple concurrent projects all needing the same machine type

Rent supplemental

Machine type needed rarely (< 3 times/year)

Rent — don't buy

Machine needed 8+ months/year on owned work

Evaluate purchase

The rent-vs-buy breakeven calculation: annual rental cost vs. annual ownership cost at projected utilization. If a compact track loader rents for $3,200/month and the owned unit costs $1,800/month at 70% utilization — owning wins at 9+ months of annual use, renting wins below that.


Charging Equipment to Jobs

Equipment cost must flow to the job cost system with the same rigor as labor and materials. Equipment that runs in overhead because "it was on the job but we didn't bill it to a cost code" distorts job cost and hides the true cost of self-perform work.

The mechanism — operator time tracking to cost codes:

When an excavator operator clocks into the construction employee time tracking app and assigns their hours to cost code 02.200 (earthwork) with equipment ID EX-04:

  • Labor cost: Operator hours × burdened labor rate → charged to cost code 02.200 (labor)
  • Equipment cost: Operator hours × internal rental rate ($35/hr) → charged to cost code 02.200 (equipment)

Both entries happen automatically from the time record — no separate equipment log required.

Rented equipment cost allocation: Invoice received → enter against project and cost code. Same as a material invoice. The invoice date matches the rental period, which matches the work period.

Idle equipment on site: A machine sitting on a project but not producing (waiting on a delivery, waiting on another trade, weather) should still be charged to the project if the contractor couldn't use it elsewhere. The decision to leave an idle machine on site vs. returning it for use elsewhere is a project management and job cost question — but the cost needs to be tracked either way.


Theft and Loss Prevention

Construction equipment and tool theft costs the industry $300 million–$1 billion annually. Small tools are the most frequent theft category by number of incidents; heavy equipment produces the largest individual losses.

Heavy equipment:

  • GPS telematics — recovery rate on stolen GPS-equipped equipment is significantly higher than non-equipped
  • Immobilizers and geo-fence alerts — machine starts outside the geo-fence triggers immediate alert
  • Serial number documentation and NICB registration
  • Proper storage and lighting at night

Small tools:

  • Tool room check-out/check-in system — worker signs out tools at start of shift, returns at end
  • Tool engraving or labeling with company ID
  • Lockable job boxes — tools secured nightly, not left in open pickup beds
  • Periodic inventory counts — weekly or bi-weekly, tool room reconciliation

GPS time tracking as theft deterrent: When workers know their location is GPS-verified during work hours, unauthorized removal of equipment after hours (outside of clocked time) stands out immediately in the records. GPS location data from operator tracking also helps confirm whether a machine was actually on site during periods of alleged theft.


Equipment Lifecycle and Replacement Decisions

Every owned machine has an economic life — the point past which the cost of repairs and lost productivity from downtime exceeds the cost of replacement.

Signals that a machine has reached end of economic life:

  • Repair cost in a single year exceeds 30–40% of machine value
  • Downtime hours exceeding 10% of available hours — the machine is idle more than it's working
  • Major component failure (engine, transmission, final drives) where repair cost approaches machine value
  • Replacement parts no longer available for the machine age/model
  • Machine doesn't meet current emissions requirements for job sites requiring EPA Tier 4

Replacement analysis: Compare annual cost of continuing to operate (repairs + downtime cost + maintenance) vs. annual ownership cost of a replacement machine at current pricing and interest rates. When the old machine's annual operating cost exceeds the replacement machine's ownership cost, replace.

Maintenance history from the equipment log informs this decision. A machine whose maintenance log shows escalating repair costs over the last 1,000 hours is trending toward replacement. Without the log, the decision is made on memory and gut feel.


Equipment Management Checklist

Fleet documentation:

  • [ ] Equipment register — all owned machines with ID, make, model, year, serial, purchase price, current value
  • [ ] Internal rental rates calculated for each owned machine
  • [ ] Assignment log — current project, operator, start date for each machine
  • [ ] Telematics or hour meter tracking system active for all heavy equipment

Maintenance:

  • [ ] PM schedule established for each machine — intervals and next service due
  • [ ] Pre-shift inspection checklist in use by all operators
  • [ ] Maintenance log current for all machines — last service date, hours, parts
  • [ ] Repair orders documented — work performed, cost, downtime duration

Job costing:

  • [ ] Equipment cost codes in job cost system
  • [ ] Operators tracking time by equipment ID and cost code via construction time keeping app
  • [ ] Equipment cost posting to job cost weekly alongside labor
  • [ ] Rented equipment invoices matched to project and cost code before posting

Fleet performance:

  • [ ] Utilization rate calculated monthly per machine
  • [ ] Downtime hours tracked by cause (maintenance, repair, weather, waiting)
  • [ ] Machines below 50% utilization flagged for rent-vs-own review
  • [ ] Repair cost per machine tracked against machine value — replacement threshold monitored

Track Equipment Cost the Easy Way with TaskTag

Every calculation in this guide — utilization rate, internal rental rate, job costing by cost code — depends on one thing: accurate operator hours by equipment ID. With TaskTag's project management software for general contractors, GPS-verified clock-ins tie directly to cost codes, so equipment cost posts to the job automatically instead of living in a spreadsheet nobody updates.

Try TaskTag free for 30 days, or book a demo to see equipment cost tracking in action.
