General Contractor Markup Guide: Rates by Trade, Fee Structures, and Margin Math

3 (14)

The average GC applies a 15–20% markup and walks away with 3–5% net profit. The gap between those two numbers — markup and actual margin — is where most construction businesses bleed out.

Markup is not margin. Overhead is not profit. A GC fee is not a markup. These distinctions cost contractors hundreds of thousands of dollars over a career because the math is applied wrong from the first estimate.

Markup vs. Margin: The Formula Most Contractors Get Wrong

Markup = Profit ÷ Cost × 100 Margin = Profit ÷ Revenue × 100

A 20% markup produces a 16.7% margin — not 20%.

Markup needed to achieve target margin:

Target Net Margin

Required Markup on Cost

10%

11.1%

15%

17.6%

20%

25.0%

25%

33.3%

30%

42.9%

35%

53.8%

Formula: Markup % = Margin % ÷ (1 − Margin %)

What the Markup Must Cover

Markup covers two things beyond direct costs: overhead (fixed costs of running the business) and profit.

Overhead rate = Annual Overhead ÷ Annual Revenue

Example — $100,000 direct cost job with 20% overhead and 10% target profit:

Item

Amount

Direct costs

$100,000

Overhead recovery

$25,000

Target profit

$12,500

Job price

$137,500

Effective markup

37.5%

Standard GC Markup Rates by Trade

[SVG chart: Horizontal bars — Self-performed labor 35–50%, Subcontractor work 10–15%, GC-supplied materials 15–20%, Equipment rental 10–15%, Residential remodel overall 20–30%, Custom home build 15–25%, Commercial TI 10–20%, Specialty trades self-perform 35–60%]

Why self-performed labor carries higher markup: your markup must cover labor burden, tools, supervision, and profit. Subs already have their overhead built in — you only mark up for coordination and GC overhead.

GC Fee Structures

Lump Sum

Markup baked in, invisible to owner. Standard on competitive bid work. Full upside and downside.

Cost-Plus with GC Fee

GC fee benchmarks:

Project Size

Typical GC Fee

Under $500K

15–20% of direct costs

$500K – $2M

10–15% of direct costs

$2M – $10M

8–12% of direct costs

$10M+

5–8% of direct costs

GC fee covers overhead AND profit. A 12% fee with 18% overhead = you lose money.

Minimum GC Fee = Overhead Rate ÷ (1 − Overhead Rate) + Target Profit %

GMP (Guaranteed Maximum Price)

Owner pays actuals up to ceiling. Add 5–10% contingency when setting the GMP.

Margin by Phase — Where Money Is Made and Lost

[SVG chart: Grouped bars — estimated 20% vs actual margin by phase. Framing and finish beat target. MEP rough-in (10%) and closeout (8%) consistently underperform.]

Fix: Add 5% contingency to MEP and closeout phases specifically. Track actuals by phase on every job.

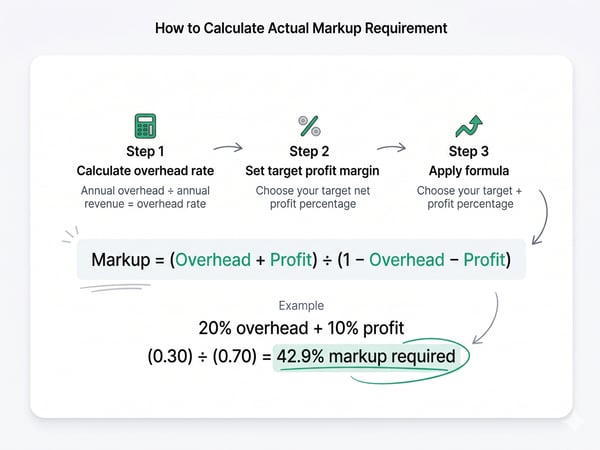

How to Calculate Your Actual Markup Requirement

1 - 2026-05-18T205321.496

Step 1 — Total all annual overhead costs ÷ annual revenue = overhead rate % Step 2 — Set target net profit margin % Step 3 — Apply formula:

Markup = (Overhead + Profit) ÷ (1 − Overhead − Profit)

Example: 20% overhead + 10% profit → (0.30) ÷ (0.70) = 42.9% markup required

Most contractors are shocked. If your overhead is 20% and you want 10% net profit, you need a 43% markup — not 20%, not 30%.

Markup Quick Reference

Situation

Markup to Apply

Self-performed labor

35–50% on labor cost

Subcontractor invoices

10–15% on sub cost

GC-supplied materials

15–20% on material cost

Equipment rental (pass-through)

10–15%

T&M work (emergency, extras)

35–50% on all costs

Cost-plus GC fee (under $500K)

15–20% of total direct costs

Cost-plus GC fee ($500K–$2M)

10–15% of total direct costs

Common Markup Mistakes

3 (15)

  1. Applying margin % as markup % — always use the conversion formula
  2. Leaving overhead costs out of the overhead rate — owner salary, estimating time, and unbilled hours are overhead
  3. One blended markup for everything — subs, self-perform, and materials deserve different rates
  4. No warranty reserve — add 1% of revenue as warranty reserve to your markup

Relevant Article:Construction Overhead and Profit: How to Calculate Your Markup (2026
