Construction Closeout Checklist: Complete Project Closeout Guide (2026)

The last 5% of a project takes 20% of the time. Unstructured closeouts delay final payment by an average of 47 days (CII, 2024). A structured 5-phase process compresses that to 7–14 days.
Key Takeaways
- Unstructured closeouts = 47-day average payment delay — structured process = 7–10 days
- Closeout has 5 distinct phases — missing any leaves money or liability on the table
- Delivering a professional closeout package doubles your 12-month referral rate (NAHB, 2025)
- Collect unconditional final lien waivers from every sub and supplier before owner final payment

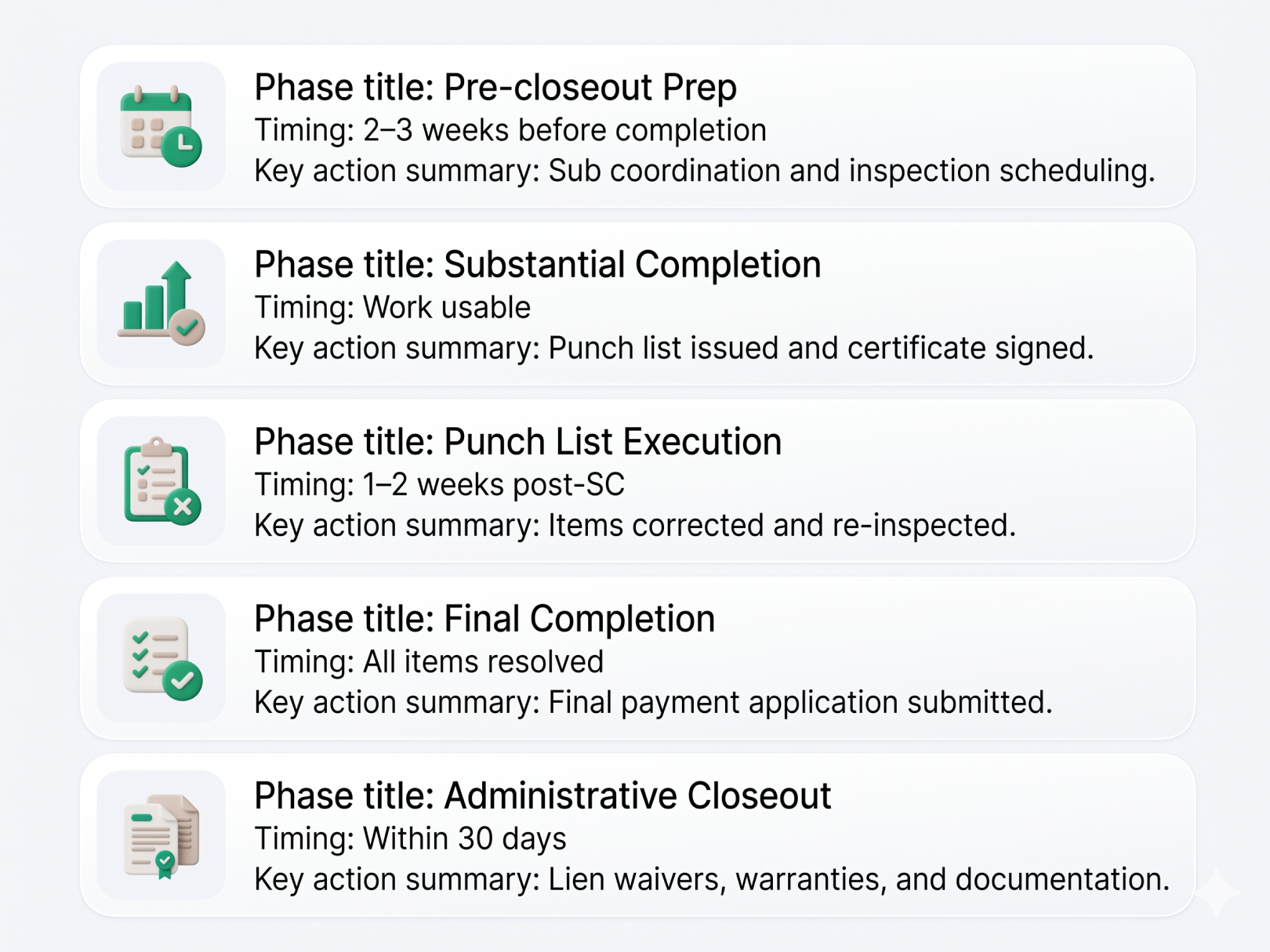

The 5 Phases of Construction Closeout

|
Phase |
Timing |
Key Actions |
|
2–3 weeks before completion |
Sub coordination, inspection scheduling |
|
Work usable |
Punch list issued, SC certificate signed |
|
1–2 weeks post-SC |
Items corrected, re-inspection, sign-off |
|
All items resolved |
Final payment application submitted |
|
Within 30 days |
Lien waivers, warranties, documentation |
Phase 1: Pre-Closeout Prep
SUBCONTRACTOR COORDINATION
[ ] All sub scopes complete or have firm completion date
[ ] Sub punch items identified — completion deadline set
[ ] All sub inspections scheduled or passed
[ ] Written notice to subs of anticipated SC date
PERMIT AND INSPECTION STATUS
[ ] All required final inspections identified
[ ] All final inspections scheduled — dates confirmed with client
[ ] Certificate of Occupancy requirements confirmed
DOCUMENTATION PREP
[ ] Begin compiling as-built drawings
[ ] Collect equipment manuals from all installed equipment
[ ] Request sub warranty letters
[ ] Prepare warranty letter
Phase 2: Substantial Completion
Substantial completion = work complete enough for the owner to use the space for its intended purpose. It starts the warranty period and typically triggers retainage release.
[ ] All major systems operational (HVAC, plumbing, electrical)
[ ] All required final inspections passed
[ ] Certificate of Occupancy received (if applicable)
[ ] Walkthrough conducted with client
[ ] Punch list issued in writing within 24 hours of walkthrough
[ ] Punch list acknowledged by client
[ ] Punch list completion deadline set (10–14 days)
[ ] Certificate of Substantial Completion signed by both parties
[ ] Progress payment application submitted for work through SC
[ ] Conditional lien waiver attached
See our construction punch list template.
Phase 3: Punch List Execution
[ ] Each item assigned to responsible party (GC / sub / owner)
[ ] Items prioritized: safety → functional → cosmetic
[ ] Each completed item documented with photo + date
[ ] Sub punch items confirmed complete
[ ] Re-inspection walkthrough scheduled with client
[ ] Client signs off on each completed item (or batch sign-off)
[ ] Any owner-accepted "as-is" items documented in writing
[ ] Revised punch list issued if any items remain outstanding
If punch list runs past 14 days: usually caused by sub availability, scope creep (client adding items that aren't deficiencies), or unclear completion criteria. Address in the contract before the next project.
Phase 4: Final Payment Application
[ ] All punch list items resolved and accepted in writing
[ ] Final invoice prepared:
- Total contract value
- All approved change orders added
- All previous payments applied
- Retainage amount
- Final balance due
[ ] Conditional final lien waiver (GC) attached
[ ] Payment terms referenced
[ ] Do not release unconditional lien waivers until
final payment clears
See our contractor invoice template.
Phase 5: Administrative Closeout
LIEN WAIVERS
[ ] GC unconditional final lien waiver → owner (after payment clears)
[ ] Conditional final lien waivers → from each sub (with their final
pay app to you)
[ ] Unconditional final lien waivers → from each sub (after you pay
them and payment clears)
[ ] Material supplier lien waivers (any large material deliveries)
[ ] No outstanding preliminary notices or liens confirmed
WARRANTY DOCUMENTATION
[ ] GC warranty letter issued (see template below)
[ ] Manufacturer warranties compiled:
[ ] Roofing [ ] Windows/doors [ ] HVAC [ ] Appliances
[ ] Flooring [ ] Other specialty materials
[ ] Sub warranty letters collected (electrical, plumbing, HVAC,
roofing, others)
AS-BUILT DOCUMENTS
[ ] Marked-up plans with field deviations noted
[ ] Approved permit set returned to owner
[ ] Concealed items documented:
[ ] Main water shutoff location
[ ] Electrical panel circuit directory updated
[ ] Gas shutoff location
[ ] Clean-out locations
OPERATIONS AND MAINTENANCE PACKAGE
[ ] All equipment manuals organized and delivered
[ ] Maintenance schedule:
- Grout sealing: 12 months post-completion
- HVAC filters: per manufacturer (typically 90 days)
- Caulk inspection: annually
[ ] Paint touch-up colors (manufacturer + formula, by room)
[ ] Specialty material care instructions
PROJECT FILE CLOSEOUT
[ ] Final job cost sheet completed
[ ] All sub invoices received and filed
[ ] All permits and inspection records filed
[ ] Photos archived (before / during / after)
[ ] Signed contract, change orders, lien waivers filed
Warranty Letter Template
CONTRACTOR WARRANTY LETTER
Date: _____________
Client: ___________________________
Project: __________________________ Completion Date: __________
[Company Name] warrants the Work at the above project as follows:
- WORKMANSHIP WARRANTY
All work performed is warranted against defects in workmanship
for ONE (1) YEAR from the substantial completion date above.
- COVERED
- Structural integrity of Contractor-performed framing
- Water infiltration at Contractor-worked areas
- Failure of installed materials due to improper installation
- Licensed sub work (electrical, plumbing, HVAC)
- NOT COVERED
- Normal wear and tear
- Owner damage, misuse, or post-completion modifications
- Manufacturer defects (covered by manufacturer warranty)
- Pre-existing conditions outside this contract
- Acts of nature
- MANUFACTURER WARRANTIES ATTACHED
[ ] Roofing: _____________ — _____ year
[ ] HVAC: _______________ — _____ year
[ ] Windows: ____________ — _____ year
[ ] Appliances: _________ — _____ year
[ ] Flooring: ___________ — _____ year
- WARRANTY CLAIMS
Contact: [Name] | [Phone] | [Email]
Response within 3 business days. Corrections within 10 business
days of confirmed warranty claim.
Contractor: ___________________________ Date: __________
License #: ____________________________
Relevant Article:TaskTag Checklists Keep Field Work on Track
Closeout Package Contents
Delivered at final payment — physical binder or organized digital folder:
[ ] GC warranty letter (signed)
[ ] Sub warranty letters (each trade)
[ ] Manufacturer warranty documents
[ ] Equipment manuals (organized by system)
[ ] Paint touch-up colors by room
[ ] Maintenance schedule
[ ] Emergency info: water shutoff, panel directory, gas shutoff
[ ] Final permit set / as-built notes
[ ] Contractor warranty service contact
A professional closeout package more than doubles your 12-month referral rate (58% vs. 24% — NAHB 2025).
Connected documents: construction punch list template · construction lien waiver template · contractor invoice template · construction change order template · construction daily report template
Sources: Construction Industry Institute — Project Closeout Benchmark Study 2024 · NAHB Remodeler Client Satisfaction Survey 2025 · AGC Project Delivery Best Practices 2024
