Construction Cost Codes: A Complete Guide for Contractors
Cost codes are the foundation of every meaningful financial measurement in construction. Without them, a contractor knows how much was spent on a project total — and nothing else. With them, the contractor knows how much was spent on framing vs. drywall vs. mechanical, whether each scope came in under or over estimate, which trade categories consistently run over budget, and exactly how many hours were charged to the change order on the north wall last Tuesday.
Cost codes make the connection between estimate, budget, and actual possible. An estimate line item for "framing — $42,000" becomes a budget cost code. Workers clock their hours into that cost code using a construction time tracking app. Material invoices are coded the same way. At any point in the project, actual cost code expenditure can be compared to budget — not as a lump sum, but line by line, scope by scope.
This guide covers how cost code systems work, the CSI MasterFormat structure most contractors use, how to build a code structure that fits your company, how to connect cost codes to time tracking and job costing, and the most common cost code mistakes that make financial data unreliable.
What Cost Codes Are

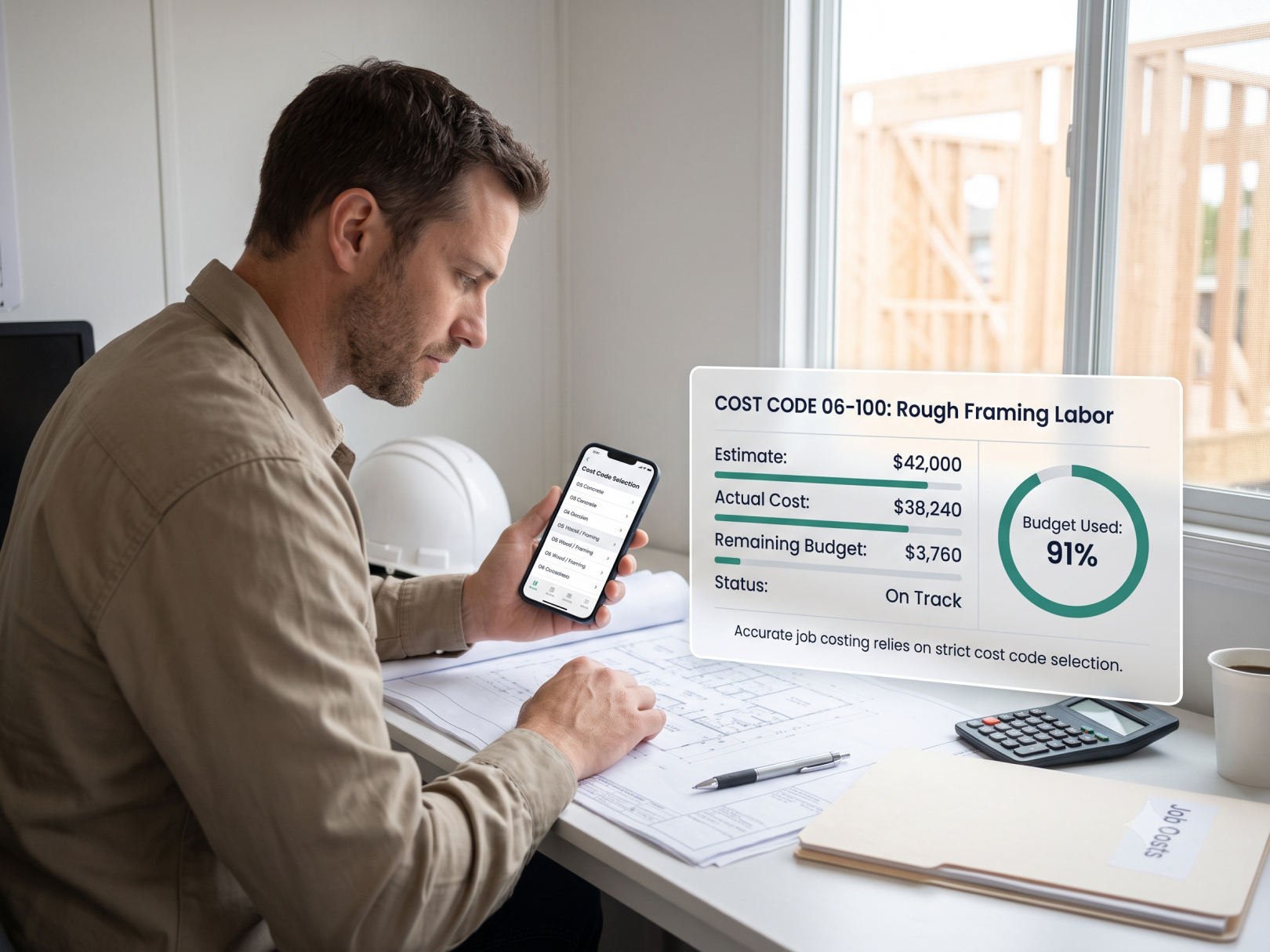

A cost code is a numeric or alphanumeric identifier assigned to a specific category of work or expense. Every cost incurred on a project — labor hours, material purchases, subcontractor invoices, equipment charges — is coded to a cost code at the time it's recorded.
The three-way connection:
ESTIMATE → BUDGET → ACTUALS "Framing labor Cost Code 06-100 Workers clock hours $42,000" Budget: $42,000 into Code 06-100 Actual: $38,240 Remaining: $3,760 Material invoices % used: 91% coded to 06-100
This connection only works if:
- The estimate is organized by cost code
- Workers clock into the correct cost code for every hour worked
- Material and subcontractor costs are coded to the matching code
Break any link in the chain and the data becomes unreliable. The most commonly broken link is #2 — workers clocking into the project without selecting a cost code, or selecting a generic "labor" code instead of the scope-specific code.
An estimate line item such as “Framing Labor – $42,000” becomes a cost code in your job cost system. Workers then clock into that cost code using a structured system like Construction Time Tracking Software
The CSI MasterFormat Framework
Most construction cost code systems use the Construction Specifications Institute (CSI) MasterFormat as their organizing structure. MasterFormat divides construction work into numbered divisions:
MasterFormat Divisions (primary):
|
Division |
Scope |
|---|---|
|
01 |
General Requirements (supervision, temp facilities, cleanup) |
|
02 |
Existing Conditions (demolition, site investigation) |
|
03 |
Concrete |
|
04 |
Masonry |
|
05 |
Metals (structural steel, misc metals) |
|
06 |
Wood, Plastics, Composites (framing, millwork) |
|
07 |
Thermal and Moisture Protection (roofing, insulation, waterproofing) |
|
08 |
Openings (doors, windows, glazing) |
|
09 |
Finishes (drywall, flooring, painting, tile) |
|
10 |
Specialties (toilet partitions, signage, louvers) |
|
11 |
Equipment (commercial kitchen, lab equipment) |
|
12 |
Furnishings |
|
21 |
Fire Suppression |
|
22 |
Plumbing |
|
23 |
HVAC |
|
26 |
Electrical |
|
27 |
Communications |
|
28 |
Electronic Safety and Security |
|
31 |
Earthwork |
|
32 |
Exterior Improvements (paving, landscaping) |
|
33 |
Utilities (underground piping, site drainage) |
Most contractors use a simplified version of MasterFormat — keeping the division structure but creating only the sub-codes relevant to their scope of work.
With cost codes tied to field reporting and time tracking tools like GPS Timesheets for Contractors
Building Your Cost Code Structure
Level of Detail: Finding the Right Depth
Too few codes: A single "labor" code for all field work tells you total hours but nothing about where overruns occur. Useless for estimating improvement and change order documentation.
Too many codes: 200+ codes creates administrative burden that field workers won't maintain accurately. Workers guess at codes rather than selecting the right one, producing garbage data.
Right depth: Enough codes to identify overruns by meaningful scope category, not so many that code selection becomes a burden. For most contractors: 30–80 active cost codes per project depending on scope complexity.
If you're implementing structured job costing within a larger system, explore how it fits into broader Construction Project Management workflows
Code Structure Options
Division-based (CSI aligned):
06-100 Rough Framing — Labor 06-110 Rough Framing — Material 06-200 Finish Carpentry — Labor 06-210 Finish Carpentry — Material 09-250 Drywall — Labor 09-260 Drywall — Material
Phase-based (sequence-aligned):
100 Site Work 200 Foundation 300 Structural 400 Envelope 500 Rough MEP 600 Insulation 700 Drywall 800 Finish MEP 900 Finishes
Hybrid (division + phase):
P1-06-100 Phase 1 Framing Labor P1-09-250 Phase 1 Drywall Labor P2-06-100 Phase 2 Framing Labor
Useful for phased projects where the same scope recurs in multiple phases and must be tracked separately for billing.
Most contractors use division-based codes aligned to CSI — consistent with spec books, subcontract scopes, and estimating software. The familiarity reduces training time when new PMs or foremen join.
Separate Labor and Material Codes
Keep labor and material in separate codes for each scope category. This allows:
- Labor efficiency ratio calculation (actual labor hours vs. estimated)
- Material cost tracking independent of labor
- Subcontractor cost tracking separate from self-perform
Combining labor and material into one code produces a single cost number that can't be analyzed — you can't tell if the framing scope ran over because of labor inefficiency or material overruns.
This is where a structured tool like TaskTag Product Features
becomes critical, because cost code selection is enforced at clock-in.
If you're evaluating software depth, compare functionality in TaskTag vs CompanyCam Comparison
CompanyCam focuses on photos — TaskTag connects time tracking, cost codes, and documentation.
Standard Cost Code Library: Commercial GC Example
DIVISION 01 — GENERAL CONDITIONS 01-100 Project Manager (indirect) 01-110 Superintendent 01-120 Project Engineer / Coordinator 01-200 Temporary Utilities 01-210 Temporary Facilities (office, toilets, fence) 01-220 Small Tools and Consumables 01-230 Dumpsters and Waste Disposal 01-240 Site Signage and Safety 01-250 Final Cleaning 01-260 Permits and Fees 01-900 Change Orders (parent — sub-codes per CO) DIVISION 03 — CONCRETE 03-100 Concrete Forming — Labor 03-110 Concrete Forming — Material 03-200 Concrete Placing — Labor 03-210 Concrete — Material (ready-mix) 03-300 Finishing — Labor DIVISION 06 — WOOD / FRAMING 06-100 Rough Framing — Labor 06-110 Rough Framing — Material 06-200 Blocking and Backing — Labor 06-210 Blocking and Backing — Material 06-300 Finish Carpentry — Labor 06-310 Finish Carpentry — Material DIVISION 07 — MOISTURE / THERMAL 07-100 Waterproofing — Labor 07-110 Waterproofing — Material 07-200 Insulation — Labor 07-210 Insulation — Material 07-300 Roofing (subcontract) DIVISION 08 — OPENINGS 08-100 Doors and Hardware — Labor 08-110 Doors and Hardware — Material 08-200 Windows (subcontract) 08-300 Glazing (subcontract) DIVISION 09 — FINISHES 09-200 Metal Framing — Labor 09-210 Metal Framing — Material 09-250 Drywall — Labor 09-260 Drywall — Material 09-300 Tile — Labor 09-310 Tile — Material 09-650 Flooring (subcontract) 09-680 Carpet (subcontract) 09-900 Painting — Labor 09-910 Painting — Material DIVISION 21–28 — MEP (subcontracted) 21-000 Fire Suppression (subcontract) 22-000 Plumbing (subcontract) 23-000 HVAC (subcontract) 26-000 Electrical (subcontract) DIVISION 31 — EARTHWORK 31-100 Excavation — Labor 31-200 Excavation — Equipment 31-300 Grading and Compaction — Labor 31-310 Grading — Equipment CHANGE ORDERS CO-001 [Description] CO-002 [Description] (Each change order gets its own code — essential for T&M documentation)
Cost Codes and Time Tracking: The Critical Connection
Every cost code system fails if workers don't clock into the right code.
A beautifully structured 60-code system produces nothing if workers clock into "Project 47 — Labor" for every shift. The data is aggregate and useless. Cost code tracking requires that every clock-in includes both:
- Project selection
- Cost code selection
A construction time clock app that requires cost code selection at every clock-in — not optional, not skippable — is the enforcement mechanism. Workers who can clock in without selecting a cost code will clock in without selecting a cost code.
What good cost code time tracking produces:
After 4 weeks on a project, the PM can see:
|
Code |
Scope |
Budget Hrs |
Actual Hrs |
% Used |
Efficiency |
|---|---|---|---|---|---|
|
06-100 |
Framing labor |
180 |
142 |
79% |
On track |
|
09-250 |
Drywall labor |
95 |
88 |
93% |
Watch |
|
09-300 |
Tile labor |
110 |
47 |
43% |
On track |
|
03-200 |
Concrete labor |
60 |
71 |
118% |
Over — investigate |
Concrete labor at 118% of budget with scope apparently 70% complete is a visible problem. Without cost code tracking, it's invisible until closeout.
Construction employee time tracking with cost code selection also enables:
- Certified payroll compliance: Hours by worker by classification — required on prevailing wage projects
- Change order documentation: T&M hours tracked to CO-specific codes with GPS verification
- Production rate calculation: Actual hours per scope item → actual production rate → improved future estimates
- Crew efficiency by foreman: Which foreman's crews consistently hit production rate targets
Connecting Cost Codes to the Estimate
The cost code structure in the estimate must match the cost code structure in the job cost system — otherwise the estimate-to-actual comparison is impossible.
Setup process when a project is awarded:
- Take the estimate line items organized by scope
- Assign each estimate line a cost code from the company standard library
- Enter estimated quantities and costs into the accounting/job cost system by cost code
- That estimate entry becomes the budget for the project
- As labor hours are clocked (via construction timesheet app) and materials are invoiced, costs accumulate against the budget by code
- Weekly job cost report shows actual vs. budget by cost code
If the estimate was organized by scope category but the cost code system uses different groupings, the comparison will never align. Standardize the estimate template to match the cost code structure from day one.
Cost Codes for Specialty Contractors
Specialty contractors (electrical, plumbing, HVAC, concrete) typically have a narrower scope range but need deeper code granularity within their trade:
Electrical contractor cost code example:
E-100 Conduit — Labor E-110 Conduit — Material E-120 Wire and Cable — Labor E-130 Wire and Cable — Material E-200 Panels and Switchgear — Labor E-210 Panels — Material E-300 Devices and Fixtures — Labor E-310 Devices — Material E-400 Gear Installation — Labor E-500 Start-up and Testing — Labor E-600 Service and Troubleshooting — Labor E-700 Change Orders (per CO)
A concrete contractor needs separate codes for formwork, rebar, placing, and finishing — because each has a different production rate and different labor cost profile. Combining them into "concrete labor" masks which sub-scope is efficient and which is not.
For landscaping contractors, see Time Tracking for Landscapers — cost code structures for landscape maintenance vs. installation differ significantly.
Common Cost Code Mistakes
- Too few codes — the "bucket" problem. One "MEP labor" code for all mechanical, electrical, and plumbing work. When MEP runs over budget, no one knows if it's mechanical, electrical, or plumbing. Each sub-trade needs its own code.
- Inconsistent use across projects. Project A uses 09-250 for drywall; Project B uses 900 for all finishes. Historical data across projects is incomparable. Standardize the code library and use it identically across every project.
- Not training workers on code selection. Workers guess at codes or select the first one on the list. Garbage in, garbage out. Train workers on the code library at project kickoff. A contractor time tracking app that shows only the codes relevant to the current project (not the full company library) reduces selection errors.
- Letting codes go to "miscellaneous." A catch-all "misc labor" code attracts hours that don't get correctly assigned. The miscellaneous code should rarely be used — every hour should have a home in a specific code. Regularly review what's accumulating in misc and reassign.
- Not tracking indirect time. Foreman coordination time, toolbox talks, site cleanup, mobilization — all consume hours that should be tracked. Either create specific codes for these or track them in the general conditions codes. Untracked indirect time inflates the apparent cost of production codes.
- No change order codes. Change order labor mixed into base contract codes produces unauditable records. Every change order — especially T&M work — needs its own cost code. The construction employee time tracking app makes this practical: create a CO code when the change is directed, start clocking into it immediately.
- Updating the code structure mid-project. Changing cost codes after the project starts breaks the historical comparison. Set up the complete code structure before the first worker clocks in. Changes mid-project require reconciling hours already coded — a manual process that's usually skipped, corrupting the data.
Cost Code Setup Checklist
Company-level (one time):
- [ ] Standard cost code library defined — 30–80 codes for typical project scope
- [ ] Library aligned to CSI MasterFormat divisions
- [ ] Separate labor and material codes for each self-perform scope
- [ ] Subcontract codes defined for major sub-trade categories
- [ ] Change order parent code defined (CO-XXX per change)
- [ ] General conditions codes defined (supervision, temp facilities, cleanup, etc.)
- [ ] Code library entered into accounting system and time tracking system
Project setup (before first day of work):
- [ ] Project-specific code list created from company library — remove irrelevant codes
- [ ] Budget entered by cost code from the estimate
- [ ] Cost codes configured in construction time keeping software — workers see only this project's codes
- [ ] Foreman briefed on code selection requirements
- [ ] Workers oriented on cost code clock-in at project kickoff
Weekly during project:
- [ ] Actual vs. budget report reviewed by cost code
- [ ] Codes running over 100% of budget investigated
- [ ] Foreman reviews and approves time by cost code before payroll
- [ ] New change order codes created when COs are directed
Cost codes connect estimating, budgeting, and actual performance. But structure alone isn’t enough — field adoption and enforcement are what make the data meaningful.
If you want to improve cost visibility and connect field reporting to job costing, you can Book a TaskTag Demo
Or start immediately with Start Your Free TaskTag Account
(Insert link on this anchor text: You can also review TaskTag Pricing Plans
For more contractor-focused resources, visit the Contractor Productivity Blog
To learn more about the company behind the platform, see About TaskTag
TaskTag Features
- GPS Time Tracking for Construction — cost code selection at every clock-in with GPS verification
- Construction Time Tracking Software Guide — cost code integration with job costing and budget tracking
- Time Tracking for Construction Workers — field clock-in by cost code for production rate and budget tracking
- Top 5 Construction Time Tracking Apps — apps with cost code configuration and job cost integration
- Top 5 BusyBusy Alternatives — cost code tracking alternatives
- TaskTag vs. BusyBusy — cost code depth and job cost integration comparison
- Time Tracking for Landscapers — cost code structures for landscape contractors
Related Blog Posts
- Construction WIP Report — cost code actuals feeding WIP by cost category
- Contractor Profit and Loss Statement — cost codes rolling up to P&L line items
- Construction Cash Flow Management — cost code tracking for cash flow forecasting
- Construction Project Closeout — cost code final reconciliation at closeout
- How to Negotiate a Construction Contract — cost code structure for cost-plus and open-book contracts
- Construction Project Delay — delay cost documentation by cost code
- Construction Defect Claims — rework cost documentation using cost codes
